What "Turnkey" Should Mean in a Renovation Contract

What a turnkey renovation contract should cover in Toronto: trades, materials, permits, disposal, the handover package, and the words that quietly shrink it.

Contracts · October 8, 2026 · 8 min read

A turnkey renovation is sold with a simple picture: you hand over the house, and later you get it back finished, with nothing left for you to organise. The word itself has no legal definition in Ontario. It means exactly what your contract says it means, and two contracts that both say "turnkey" can describe very different amounts of work and responsibility.

This guide sets out what the word should cover, where it usually stops, and how to read the wording so the gaps are found on paper rather than in the middle of the job. It is written for houses and condos in Toronto and the GTA.

What does "turnkey" mean in a renovation contract?

In a renovation, turnkey should mean one company is responsible for everything needed to deliver the finished space: the trades, the materials, the permits and inspections, protection of the house, disposal, final cleaning and the handover. You make decisions and approve changes. You should not be the person who books the plumber, chases a late delivery or finds out a tile was never ordered.

The useful test is simple. For every task on the job, ask who is responsible if it is late, wrong or missing. In a true turnkey contract the answer is the contractor every time, except for items the contract names as yours.

How is turnkey different from other ways to hire a contractor?

Most renovations are hired in one of four ways. They differ less in who swings the hammer than in who carries the gaps between trades: the missing blocking, the late cabinet, the inspection nobody booked. Turnkey puts all of those gaps on the contractor; the other arrangements leave some or all of them with you.

ArrangementWho runs the tradesWho buys the materialsWho owns a gap between trades
TurnkeyThe contractor, all of themThe contractor, from your approved selectionsThe contractor
Labour onlyThe contractorYou, delivered on the right dayShared, and argued about when a product arrives wrong
Separate tradesYou, one contract per tradeEach trade, or youYou
Design by others, build by contractorThe contractor, to someone else's drawingsDepends on the contractSplit between designer and contractor where the drawings are silent

None of these is wrong. A homeowner who already has a trusted electrician, or who wants to source every fixture personally, may be better served by labour only. The point is to know which one you are signing, because a contract titled "turnkey" can quietly read like labour only once you reach the exclusions.

What should a turnkey contract actually include?

A turnkey contract should list the work from demolition to handover and, alongside it, the services that hold the job together: ordering and receiving materials, booking inspections, protecting the house, removing waste and cleaning. Those services are what you are paying a single contractor to take off your hands, so each one belongs in writing.

ResponsibilityWhat the contract should sayWhat happens when it is silent
Ordering and receivingThe contractor orders from your selections, checks each delivery and handles returns of damaged itemsA chipped vanity sits in the garage while you phone the supplier
Licensed tradesElectrical, plumbing and HVAC named as included, done by licensed tradesA separate invoice for the electrician, or work done without the right licence
Permits and inspectionsWho applies, who pays the fees, who books each inspection and who closes the permitAn open permit on your property record that surfaces when you sell
Protection and dust controlFloor and stair protection, dust walls, covered vents in rooms that stay in useScratched hallway floors and drywall dust through the furnace
Waste and disposalBins or haul-away included, and where a bin may sitA pile of old cabinets left for you, or a bin on the street without a permit
Making goodPatching and painting where the work touched adjacent rooms or the ceiling belowA finished kitchen next to a hallway with fresh holes in it
Final clean and handoverA construction clean, a walk-through, and the documents listed further downDust on every surface and no record of what was installed

If you are comparing several bids, our guide on telling a good contractor quote from a bad one covers allowances and payment stages, which matter just as much in a turnkey job.

Where does turnkey usually stop?

Even a genuine turnkey contract has edges, and the honest ones name them. These items are commonly outside the scope unless the contract brings them in. None is a problem as long as both sides know about it before work starts.

  • Appliances: often supplied by the owner. Who receives them, unboxes them, connects water and gas, and takes the packaging away should still be written down, because that is where turnkey jobs leave loose ends.
  • Furniture, window coverings and moving your belongings: rarely included. Ask whether rooms must be empty before a given stage.
  • Hazardous materials: asbestos in older plaster, joint compound, flooring or vermiculite insulation is removed by specialists under Ontario's asbestos regulation for construction projects (O. Reg. 278/05). Many contracts exclude it and treat it as a change if it is found.
  • Hidden conditions: rot, undersized framing or old wiring behind a wall. A good contract says how these are priced and approved when they turn up, rather than pretending they will not.
  • Condo building services: elevator bookings, deposits and the alteration agreement are set by the corporation. Our guide to condo renovation rules explains who usually handles them.

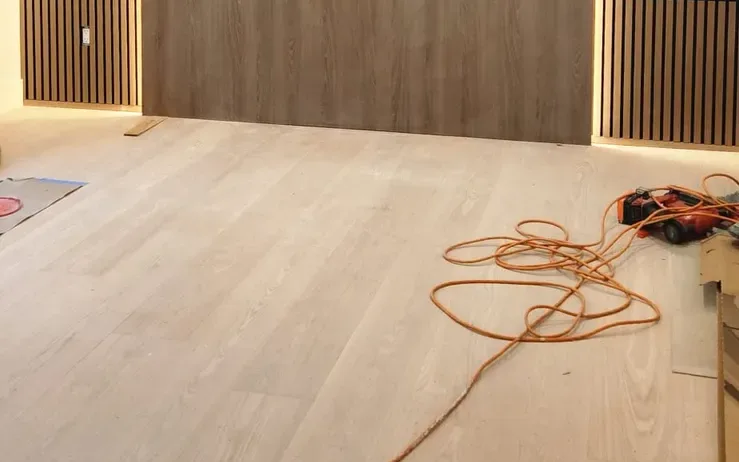

Light oak plank floor in front of a wall of wood panels and slatted panels with LED strips glowing at their edges, an orange extension cord and power tools still lying on the floor
A room can look finished while the job is still running: tools on the floor and trim still to fit. Turnkey ends at handover, not when the feature wall lights up.

Does turnkey mean a fixed price?

Not on its own. Turnkey describes who is responsible; the price can still be fixed, a stated estimate, or partly made of allowances for items you have not chosen. What protects you is a defined scope with named products, and a written change process, whatever the label on the front page says.

Ontario's Consumer Protection Act helps here. If a contractor gives you an estimate, the Act says they may not charge more than 10 per cent above it unless you agree to the higher amount. Changes you request are a different matter, which is why each one should be written up and signed before it is built. A contract signed in your own home rather than at the contractor's office is also a direct agreement under the Act, which gives you a 10-day cooling-off period.

Vague: "Turnkey kitchen renovation as discussed."

Clear: "Contractor supplies and installs the cabinets, counters, backsplash tile and plumbing fixtures listed in Schedule A; applies for and closes the building permit; arranges ESA inspection of the electrical work; removes all demolition waste; and completes a final clean. Owner supplies the four appliances listed in Schedule B; Contractor receives, installs and connects them."

The second version is longer, but every sentence in it can be checked on site. That is the whole difference between a label and a scope.

What should you receive on the day you get the keys back?

Handover is where turnkey proves itself. The house should be clean, every system should work, and you should be given a folder of the records you will need later, when something fails, when you insure the house or when you sell it. Ask for this list to be part of the contract, not a favour at the end.

  1. Permit records: confirmation that the City of Toronto, or your local municipality, has passed the final inspection and closed the permit. Our guide to Toronto renovation permits covers which jobs need one.
  2. Electrical inspection: the Electrical Safety Authority's record that the electrical work passed inspection.
  3. Product list: the make, model and colour of every fixture, tile, counter, cabinet finish and paint, including paint codes and sheen for each room.
  4. Manuals and registrations: for appliances, fans, water heaters, thermostats and anything with a manufacturer's registration card.
  5. Leftover materials: a few spare tiles from the same batch, a labelled can of each paint and spare flooring. Matching a tile batch years later is often impossible.
  6. The closed deficiency list: the walk-through list, signed off item by item.
  7. Who to call afterwards: the contractor's process for anything found after handover, written down.

Which contract words quietly shrink a turnkey job?

A few short phrases move work back onto you without looking like exclusions. Read the contract once looking only for them. Each one is fine if you agreed to it, and a problem if you only notice it when the work stops.

"By owner" and "owner to supply"

Every line marked this way is yours to buy, deliver on time and replace if it arrives damaged. Count them. A turnkey contract with a long "by owner" list is closer to labour only.

"Install only"

The contractor fits the product but is not responsible for choosing, ordering or the product itself. If the faucet leaks from its own cartridge, that is between you and the store.

"Coordinate with"

Coordinating with your electrician is not the same as including electrical work. The phrase usually means another contract, paid by you, that the contractor will schedule around.

"Ready for"

"Ready for countertop" or "ready for paint" means the work stops at that stage. Somebody still has to template, fabricate and install the counter, or paint the room. Check who.

How do you hold a contractor to the turnkey promise?

Turn the word into a list before you sign: the scope, the products, the services, the exclusions and the handover documents. Then hold payments to stages you can see, and keep every change in writing. A contractor who means turnkey will be comfortable writing all of it down; reluctance to do so tells you how the word is being used.

Art Style Construction runs full projects across Toronto and the GTA as a general contractor, from single rooms to whole-home renovations and kitchens. If you are planning one, book an on-site consultation and bring the contract questions with you; we would rather settle them on paper than in the middle of your job.

Questions homeowners ask about this

What does turnkey mean in a renovation?

It should mean one contractor is responsible for delivering the finished space: trades, materials, permits and inspections, protection, disposal, cleaning and handover. The word has no legal definition in Ontario, so it only covers what the written contract lists. Read the scope and the exclusions, not the label.

Is a turnkey renovation a fixed price?

Not automatically. Turnkey describes responsibility, not pricing. The contract can still be a fixed price, an estimate or partly allowances. Under Ontario's Consumer Protection Act, a contractor who gives an estimate may not charge more than 10 per cent above it without your agreement; changes you ask for are priced separately.

Are appliances included in a turnkey renovation?

Often not. Many contracts have the owner supply appliances. Even then, the contract should say who receives them, installs them, connects water and gas, and removes the packaging, because those small tasks are where turnkey jobs most often leave loose ends.

What documents should I get at the end of a renovation?

Ask for the closed building permit, the electrical inspection record, a list of every product and paint colour installed, manuals for appliances and equipment, spare tile, flooring and paint, and the signed-off deficiency list. Put this list in the contract so it is not left to goodwill.
